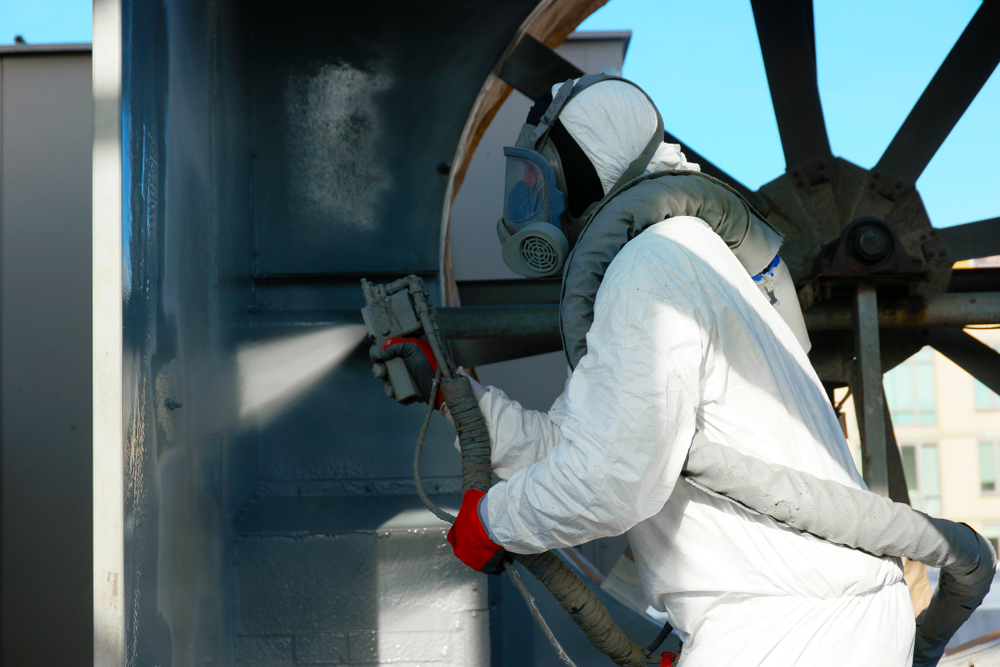

Getting Polyurea Right: 7 Key Factors for a Successful Containment Installation
Polyurea is a proven choice for chemical and industrial containment, but its performance depends entirely on how well it’s installed.
Even the highest-quality polyurea spray system can fail prematurely when surface prep, environmental conditions, or application technique fall short.
This guide outlines the seven critical factors that determine whether a polyurea installation delivers long-term protection — or becomes a costly rework.
The Top Conditions That Determine Whether Polyurea Performs—or Fails
Before applying polyurea coating spray, installers must control a specific set of conditions that directly influence adhesion, cure quality, and long-term performance.
These seven factors define the foundation of a successful containment spray installation:

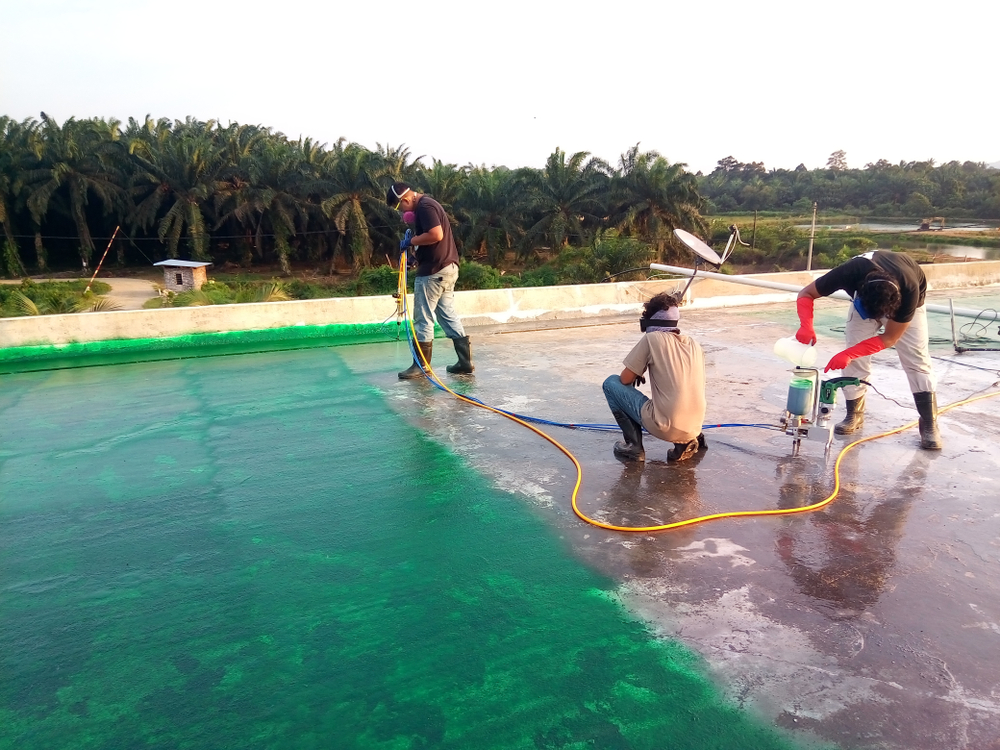

1. Start With Proper Surface Preparation
Proper surface preparation is the single most significant predictor of long-term polyurea performance. More than 80% of adhesion failures can be attributed to substrate issues, rather than the coating itself.
Before any spray work begins, installers must ensure the substrate is clean, profiled, and primed for bonding.
What surface preparation is required for a polyurea installation?
- Concrete: Remove laitance, curing compounds, and contamination; achieve an ICRI CSP 3–5 profile using mechanical prep.
- Steel: Blast to the required anchor pattern (typically SSPC-SP10/NACE 2) and remove rust, mill scale, and old coatings.
Do I need a primer for polyurea spray?
Primers are mandatory in most containment environments, especially on porous, deteriorated, or moisture-prone substrates. They promote chemical bonding and prevent outgassing during the curing process.
How to verify the substrate is ready:
- Check the profile with replica tape or depth gauges.
- Test for dust or contaminants after mechanical prep.
- Confirm primer coverage and cure window before spraying.
2. Control Moisture and Temperature Conditions of the Environment
Polyurea’s fast-reacting chemistry means environmental conditions can make or break adhesion. Controlling moisture, temperature, and dew point is just as important as surface prep.
Key environmental controls:
- Dew point: Surface temperature must remain at least 5°F above the dew point to prevent condensation.
- Concrete moisture: Use moisture meters or calcium chloride tests to confirm acceptable levels.
- Temperature: Ambient, substrate, and material temperatures must be within the manufacturer’s specifications — typically 60–90°F for most systems.
What happens if you spray polyurea on a wet surface?
Moisture causes blistering, pinholes, foaming, and complete delamination, often within a matter of hours.
Best practices for monitoring the polyurea installation environment:
- Monitor conditions continuously, not just at start-up.
- Use stage heaters, dehumidifiers, or enclosures when working in cold or humid environments.
3. Calibrate Your Polyurea Equipment Correctly
Polyurea requires precise A/B ratios and stable pressure to react correctly. Slight deviations can lead to brittle, soft, or uncured material. These failures typically don’t appear until the system is in operation.
How do I know if my polyurea mix ratio is wrong?
- Off-ratio material may appear glossy, oily, soft, or brittle.
- Cure times may be longer than expected.
- Spray patterns may show “fingers,” pulsing, or poor atomization.
Critical polyurea equipment checks:
- Verify the 1:1 ratio on proportioners daily.
- Maintain proper material and hose heat for viscosity control.
- Set an accurate pressure balance between the A and B sides.
- Inspect filters, screens, and check valves before each shift to ensure optimal performance.
Consistent calibration eliminates many of the issues that cause field failures and rework.

4. Apply Polyurea Spray Using a Consistent Technique
Even with perfect prep and calibration, a poor spray technique can create weak spots, thin areas, or excessive buildup that compromises containment integrity.
Polyurea application best practices:
- Use 50% overlap patterns to ensure uniform coverage.
- Follow a defined pass sequence (typically vertical passes first, then horizontal).
- Build thickness in controlled layers to achieve the specified thickness (often 80–120 mils for containment).
- Continuously inspect for sags, holidays, and thin areas using wet film gauges or visual checks.
Uniform film build is one of the strongest predictors of long-term performance.

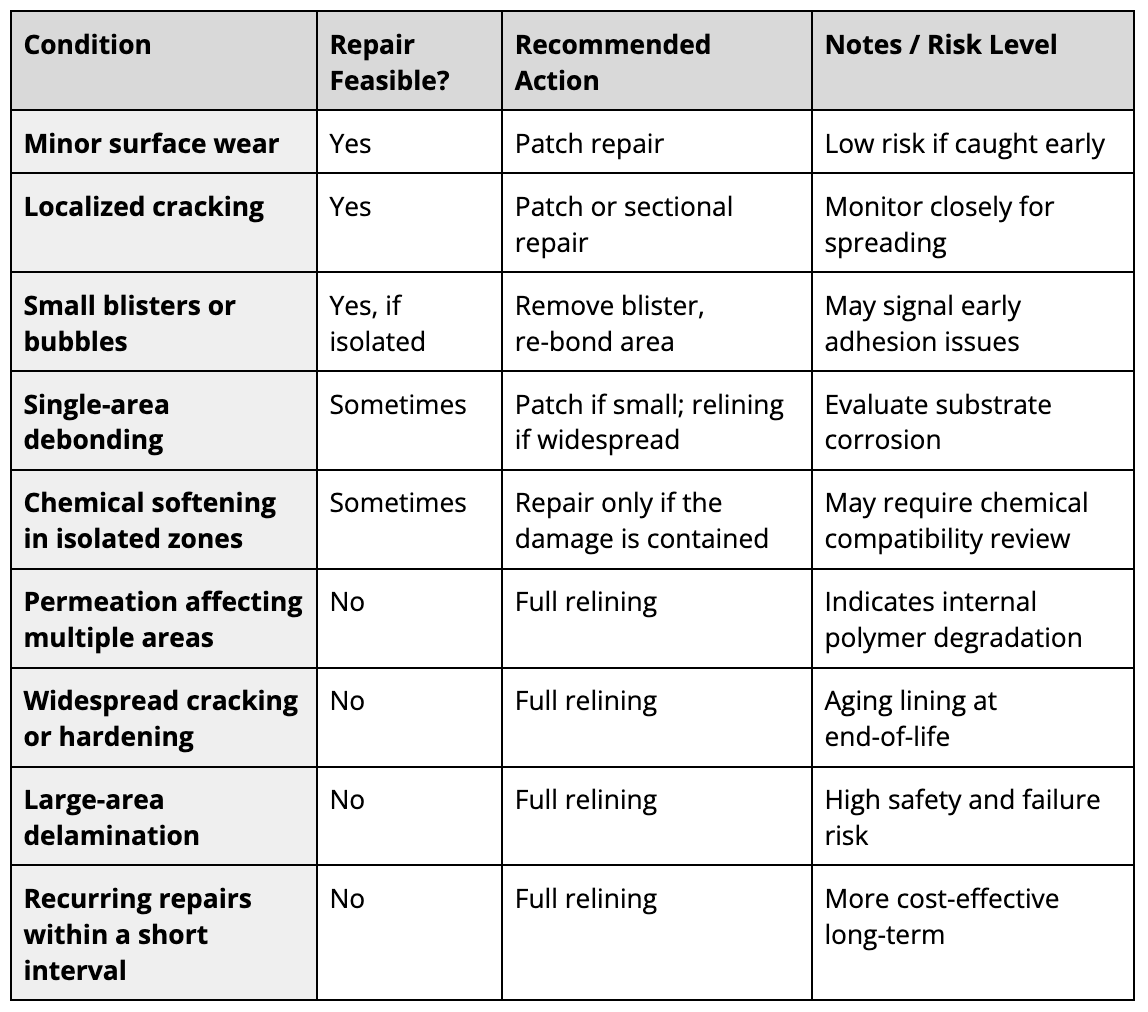

5. Avoid the Most Common Polyurea Application Mistakes
These errors cause the majority of premature failures, and all are preventable with the proper process controls:
Common Polyurea Installation Mistakes:
- Spraying over damp surfaces or hidden condensation
- Incorrect or unstable mix ratio
- Inadequate surface preparation
- Skipping primer when required
- Applying material too thick in a single pass
- Failing to maintain temperature control during application
How To Prevent These Polyurea Installation Mistakes:
- Measure moisture, temperature, and dew point before and during the installation process.
- Perform daily equipment calibration and spray tests.
- Use mechanical surface prep and document profile verification.
- Follow the manufacturer’s thickness limits per pass.
- Implement a supervisor-level QA review at each stage of the process.
6. Perform QA/QC Checks Before Calling the Job Polyurea Application Complete
A polyurea containment lining is only as strong as the verification behind it. Proper QA/QC ensures the system meets specifications today and continues to protect assets for years to come.
Required verification steps:
- Adhesion pull tests: Confirm bond strength to substrate.
- Spark testing: Detect holidays and pinholes in nonconductive linings.
- Wet and dry film thickness checks: Validate uniformity and compliance with spec.
- Documentation: Record environmental conditions, material batch numbers, prep methods, and test results for audits and warranty support.
A disciplined QA/QC process dramatically reduces the risk of service failure.
7. Know When a Turnkey Polyurea Team Reduces Risk
For high-value containment systems, coordinating multiple contractors introduces unnecessary risk. A turnkey polyurea provider handles prep, application, testing, and documentation as one integrated workflow.
Why turnkey installation matters:
- Fewer handoffs mean fewer delays, prep mismatches, or communication gaps.
- Unified teams ensure surface prep and application are aligned, eliminating the #1 cause of adhesion failure.
- Professional installers follow strict QA/QC processes that protect against early breakdown.
- Overall cost is lower when the system performs as intended — not when it needs to be repaired or replaced.
Turnkey service maximizes reliability and minimizes downtime, especially in critical containment environments.

Always Protect Your Containment System With Proven Polyurea Expertise
Polyurea is one of the strongest, most reliable containment lining materials available—but only when the installation process is tightly controlled from start to finish.
If you want a system that lasts, you need a team that understands:
- Substrate preparation
- Environmental conditions
- Equipment calibration
- Application technique
- Disciplined QA/QC
US FUSION delivers all of this in a single-source service model designed to reduce risk and guarantee performance.
Do you need support with an upcoming containment project? Contact our team to receive a quote.
